Technical

Mace’s Piccadilly makeover uses 77% recycled steel

Helping 30 Duke Street St James’s to fully embrace the circular economy, more than three-quarters of its structural frame is reclaimed steelwork, making it the largest steel reuse project for a commercial office in the UK to date. Martin Cooper reports

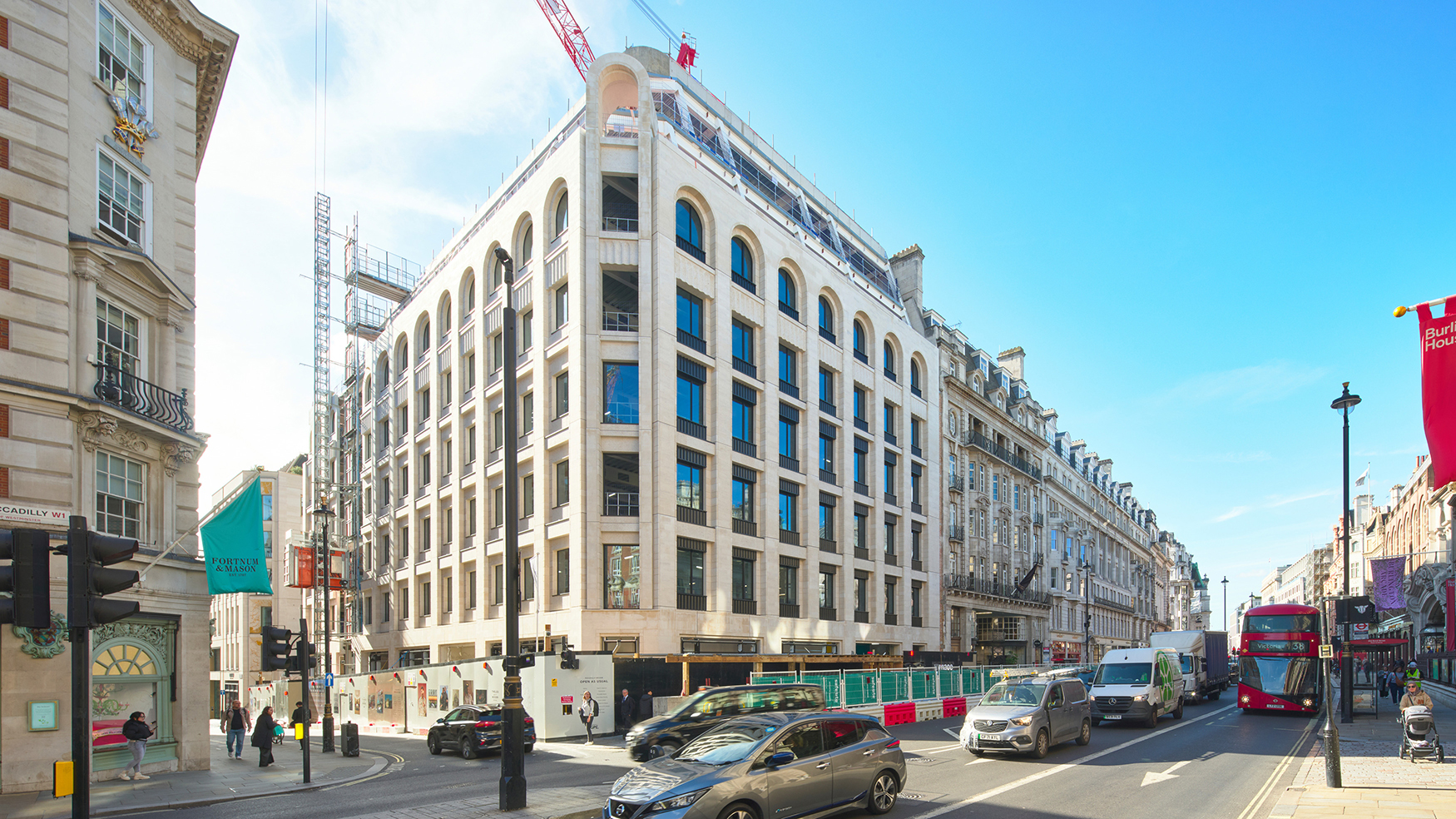

The project has a busy location on Piccadilly. Image: Alignment Media
The project has a busy location on Piccadilly. Image: Alignment Media

Located in the heart of London’s West End, sustainability has taken centre stage in the design and construction of a steel-framed commercial scheme at 30 Duke Street St James’s.

Replacing two buildings (50 Jermyn Street and French Railways House, which fronted Piccadilly), the new eight-storey development will have its main entrance on Duke Street, the thoroughfare that connects the two aforementioned roads.

As well as aiming to achieve BREEAM ‘Outstanding’ and WELL Platinum accreditations, this project’s credentials are boosted by the fact that approximately 77% of its structural frame consists of reclaimed steel, obtained from a number of different sources.

30 Duke Street St James’s, London

Main client: GPE
Architect: Make Architects
Main contractor: Mace
Structural engineer: Elliott Wood
Steelwork contractor: William Hare
Steel tonnage: 559t

By far, the largest portion of this total (67% or 375t), was sourced from the demolition of City Place House, which is another London scheme within developer GPE’s portfolio (see box).

Reclaiming and reusing materials is all about making good use of what is available. With that in mind, a small quantity of steel (3t which previously formed a plant deck) was also salvaged from the demolition of the concrete-framed French Railways House.

The remainder of the project’s steel frame contains material from Cleveland Steel and European Metal Recycling’s (EMR) stock of reclaimed steelwork, as well as a quantity of new sections.

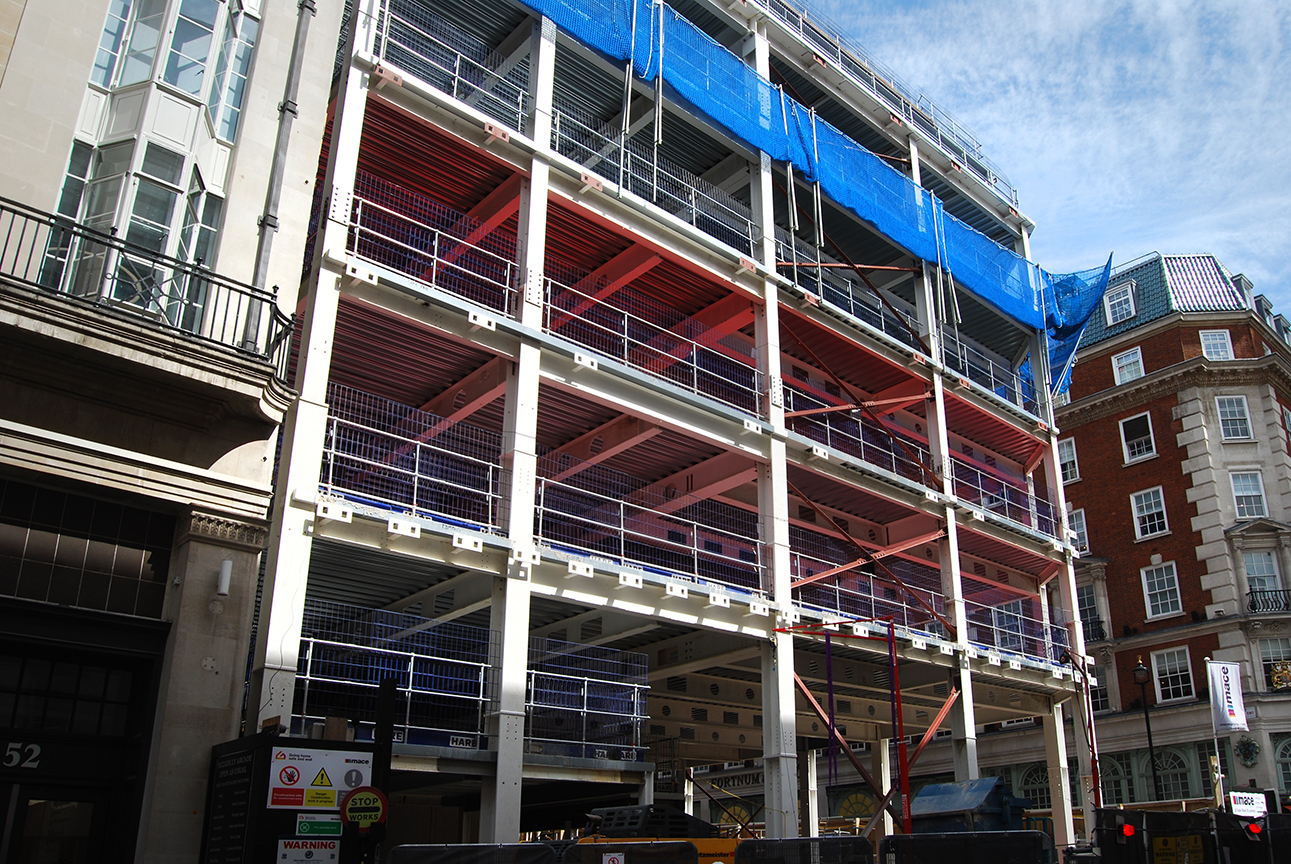

Steel erection on Duke Street St James’s. Image: Alignment Media
Steel erection on Duke Street St James’s. Image: Alignment Media

“There is a significant carbon saving associated with using steel, as it also lends itself to prefabrication, which reduces the amount of work needed on site. The reclaimed steel approach has achieved an impressive embodied carbon saving of 744t CO2e,” says Mace operations director Sal Capotosto.

Steelwork is not the only reused material on the project, there is also a significant quantity of reclaimed aluminium as well as Portland stone, which will be used on the building’s facade.

Adding to the circular economy and helping to record all of the materials used, this scheme is one of the first projects to make use of a pioneering new concept known as materials passports.

These digital data sets, describe characteristics of materials and components, giving them value for present use, recovery and future reuse. In this way, the project is designed as a storage bank where materials are held for future reuse and recovery.

“Early on, the client bought into the idea of the passports,” says Capotosto. “They were the real driver behind the collaboration we needed from many of our team members and supply chain to make this project’s reuse philosophy work.”

The new steelwork sections for the project amounted to approximately 54t and were fabricated, supplied and erected by William Hare as part of the overall steelwork package. The company also installed 64t of new bolted connections within the main frame and refabricated all of the reclaimed material, once it had been repurposed.

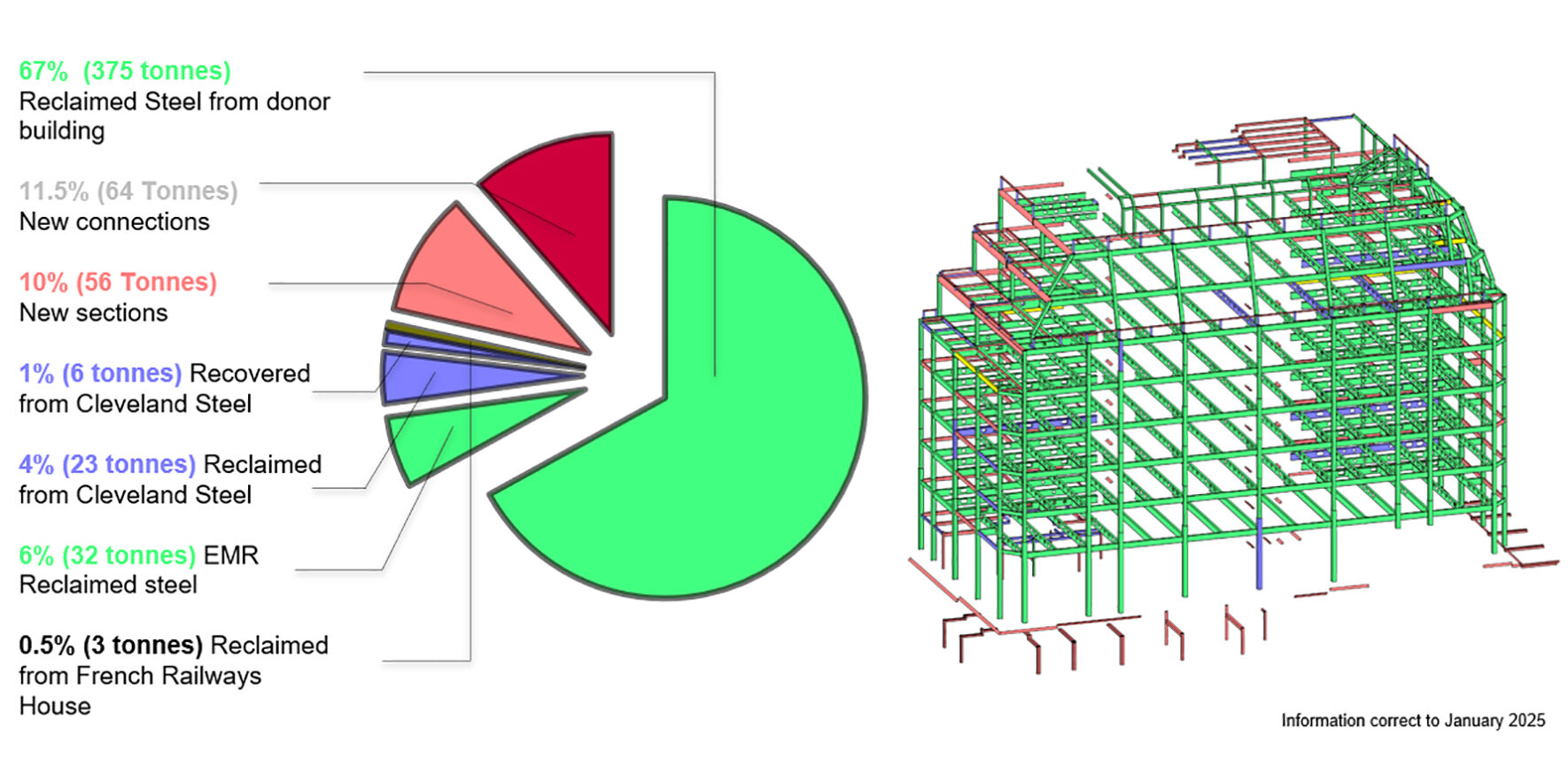

Sources of the reused steel on the project. Image: Alignment Media
Sources of the reused steel on the project. Graphic: Alignment Media

Many of the reclaimed beams were too long for this scheme’s design and had to be cut to length, while some column sections were spliced together (up to three in some locations) to form the required sectional height.

Bespoke openings were also cut into the previously solid beam sections, re-fabricating them into cellular members that accommodate the building services within their depth.

William Hare project director Simon Bourne says: “This project is a brilliant example of how innovation and collaboration can drive meaningful change in the built environment. We’re proud to have contributed to a scheme that not only redefines sustainable construction but also delivers tangible carbon savings through the reuse of structural steel.”

In addition to the many sustainable benefits, the use of steelwork has also allowed the design to create the open-plan office floorplates the client wanted.

This has primarily been achieved by positioning the stability-giving concrete core, which contains lifts and staircases, in an off-set location along the building’s western party wall.

In many commercial buildings, the core is often placed in a central position, but on this project, that would have eaten up too much valuable floor space.

From the offset core, the steel beams, which span up to 13m-long, radiate outwards to the north, east and south elevations, forming column-free internal areas on every floor.

The long span internal beams support metal decking and a concrete topping, forming a composite flooring solution for every level.

Image: Alignment Media
Long-span internal beams form composite flooring for every level. Image: Alignment Media

Overall, the steel frame starts at ground floor and sits atop a concrete ground floor slab and a single-storey basement, which has been retained from the previous scheme.

In the completed building, the basement and ground floor will house retail units, while also accommodating the main entrance lobby and reception.

The ground floor is a double-height space throughout, creating plenty of flexibility. This is highlighted by the fact that one retail unit comes replete with a steel-framed mezzanine level.

From the first floor upwards, the building consists entirely of office spaces, with terraces wrapping around the southern elevation on the uppermost three levels.

Up to and including level five, the building is clad with precast panels, which were prefabricated offsite, while the upper floors feature a mansard with dormer windows, which is a nod to the surrounding architectural landscape. The mansards, which are framed with steel, arrived on site as complete units, reducing the number of crane lifts required for the steel programme.

CGI of the completed development. Image: Alignment Media
CGI of the completed development. Image: Alignment Media

GPE executive director Dan Nicholson, says: “This is a brilliant opportunity for us to create best-in-class office and retail spaces in the heart of St James’s.

“Sustainability is at the core of the development, and we are setting a precedent for London by reusing structural steelwork.”

30 Duke Street St James’s is due to complete in mid-2026.

Donor building provides reused steel

GPE says it is committed to reducing the carbon footprint of its developments and is engaged in reclaiming and reusing steelwork wherever possible. The demolition of the 1990s-built City Place House, located a short distance from London’s Moorgate Station, provided 1,800t of salvaged steelwork.

As well as reusing some of this material on the Duke Street St James’s project, around 80t was incorporated into the steel frame of 2 Aldermanbury Square, (a 13-storey office block built on the site of City House Place) with the remainder being stored for future use.

“The existing steel frame included long-span beams without penetrations, making it an ideal opportunity for reuse,” explains Arup project engineer Jamie Page.

“To facilitate this sustainable and circular economy approach, the demolition process was planned and executed to allow for the steelwork to be removed at maximum length without damage.”

William Hare subsequently refabricated the steelwork into trimmers, which have been erected around the main core and risers at 2 Aldermanbury Square, as well as beams and columns to form its rooftop plant deck.
